How to Set Up a 200-Worker Labour Camp in 30 Days

A day-by-day plan for a 200-worker prefab labour camp: layout, parallel execution, utilities, checklist and common mistakes.

200 worker prefab labour camp setup in India
Quick answer

With early design freeze, off-site manufacturing and site preparation running in parallel, a 200-worker prefab labour camp can potentially be planned and installed within a 30-day mobilisation window — subject to site readiness, approvals, material availability, transport and foundation requirements.

Setting up accommodation for 200 workers is not just about putting up rooms and beds. For an EPC contractor, infrastructure company, construction company or industrial project, a functional labour camp needs accommodation, toilets, bathrooms, drinking water, electricity, ventilation, kitchen and dining facilities, drainage, waste management and other essential services.

With proper planning, off-site preparation and parallel execution, a 200-worker prefab labour camp can potentially be planned and installed within a 30-day mobilisation window, subject to site readiness, design approval, material availability, transportation, foundation requirements and project specifications.

Why a 30-day labour camp setup is challenging

A 200-worker accommodation project involves multiple activities happening simultaneously: worker dormitories, beds, toilets, bathrooms, kitchen, dining/mess, drinking water, electrical distribution, lighting, ventilation, drainage, waste management, storage, common areas, security arrangements, fire and safety provisions and site preparation.

If these activities are handled one after another, the project timeline can quickly extend beyond 30 days. The key is to plan early, manufacture in parallel and prepare the site while prefab components are being produced.

Why prefab construction works well for fast labour camp setup

A traditional labour colony requires substantial construction at the project site. Prefab changes the sequence: Designed → Manufactured/Prepared → Transported → Assembled → Connected → Finished.

This can reduce on-site work and help manage faster installation, more predictable construction, reduced wet work, better material control, reduced site labour dependency, easier expansion and potential future relocation.

Step 1: Finalise the 200-worker requirement

Determine exactly what the camp needs to accommodate. If eight workers are accommodated per dormitory, 200 ÷ 8 = 25 dormitory rooms.

The final layout should also consider room size, bed arrangement, walking space, ventilation, windows, doors, storage, electrical points, emergency exits and toilet access. A well-designed camp should avoid overcrowding simply to reduce construction cost.

Step 2: Prepare a complete labour camp layout

A typical 200-worker labour camp may contain:

  • Accommodation zone — dormitories and storage.
  • Sanitation zone — toilets, bathrooms and wash areas.
  • Food and dining zone — kitchen, mess and food storage.
  • Utility zone — electrical, water and waste systems.
  • Support facilities — security, site office, common areas and internal pathways.

The exact layout should be adapted to the available site and applicable requirements.

Step 3: Decide the required built-up area

Do not use a generic formula for total area. The required built-up area depends on beds per room, room size, toilet arrangement, kitchen, dining capacity, common areas, circulation, storage, site office and utility spaces. A proper layout should be prepared before final costing.

Step 4: Choose the right prefab construction system

Select the system according to project duration, local climate, number of workers, occupancy, insulation, budget, transportation distance, foundation requirements and relocation requirements.

Depending on the project, a prefab labour camp may use an MS structural framework, PUF insulated panels, EPS panels, other insulated wall systems, roofing systems, prefabricated doors and windows, modular flooring, electrical and plumbing systems. Thermal insulation deserves particular attention in hot Indian climates.

Step 5: Freeze the design before manufacturing

Before production begins, confirm room dimensions, number of rooms, doors, windows, toilet locations, electrical points, plumbing routes, kitchen layout, mess capacity, roofing, flooring, panel specifications, finishes and utilities. Once the design is frozen, manufacturing and site preparation can proceed in parallel.

Step 6: Prepare the site while components are being manufactured

Do not wait for prefab components to arrive before starting site work. While components are manufactured, the site team can work on site clearing, levelling, marking, foundation preparation, drainage, water connections, electrical arrangements, access roads and material unloading areas.

This creates a parallel workflow: Manufacturing + Site preparation + Utility planning.

30-day labour camp execution plan

DaysStageWhat happens
1–3Requirement & design finalisationConfirm workforce capacity, room occupancy, site dimensions, layout, facilities and specifications.
4–7Engineering & site preparationDrawings, structural requirements, panel specifications, levelling, foundation/site preparation, water/drainage, electrical provisions and logistics. Begin manufacturing.
8–15Manufacturing + civil/utility workStructural components, wall panels, roofing, doors, windows, flooring, electrical and plumbing materials — while foundation, drainage, water, electrical and access work continue.
16–20Transportation & installationTransport in installation sequence. Install framework, panels, roofing, doors/windows, flooring, partitions, electrical and plumbing.
21–25Services & finishingElectrical, lighting, ventilation, plumbing, toilets, bathrooms, kitchen, flooring, touch-ups, water and drainage connections.
26–28Furniture & equipmentBeds, bunk beds, mattresses, tables, storage, kitchen equipment, dining furniture, waste bins and safety equipment.
29–30Inspection & handoverQuality inspection, electrical testing, plumbing checks, water testing, drainage inspection, safety review, cleaning and defect correction.

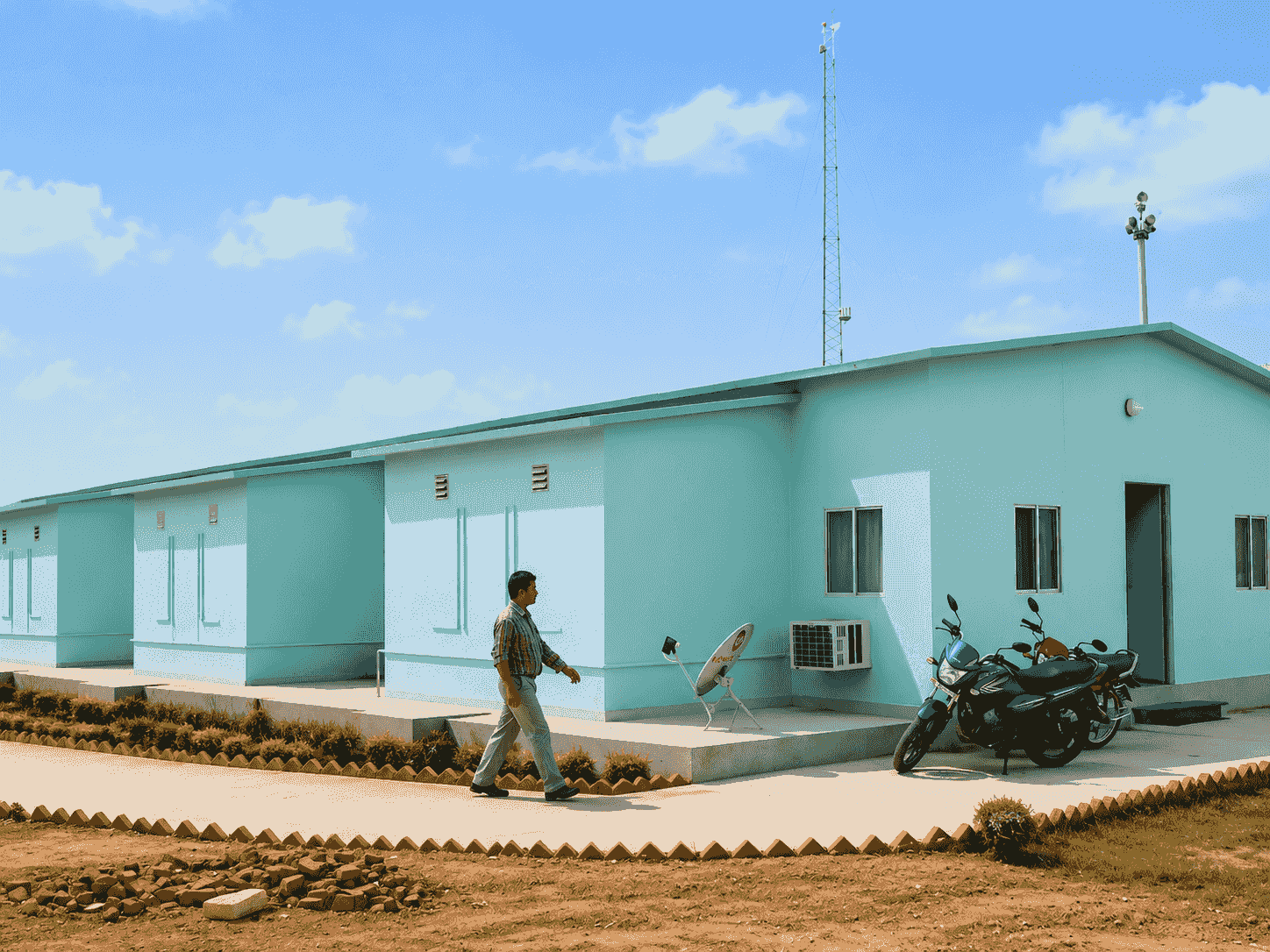

Prefab worker accommodation blocks at a construction site
Accommodation blocks installed in sequence while services and utilities are completed in parallel.

What should a 200-worker labour camp include?

A functional camp should be designed around actual worker requirements. Key components include worker accommodation, beds/bunk beds, storage, ventilation, toilets and bathrooms, kitchen and mess, drinking water, electricity, thermal comfort, drainage, waste management, common areas and appropriate safety provisions.

Toilets & bathrooms

Sanitation is one of the most important components. The design should consider number of users, toilet-to-worker ratio, showers, wash basins, water supply, drainage, cleaning access and ventilation. Applicable local/project requirements should be checked before finalising the design.

Kitchen & mess

For 200 workers, food preparation and dining require proper planning. Facilities may include cooking area, food preparation counter, storage, washing area, dining tables, ventilation, water supply and waste disposal.

Drinking water

The camp should have an adequate drinking-water arrangement based on the workforce. Depending on the site, this can involve water storage tanks, filtration/purification, distribution lines and drinking water points.

Electricity

Electricity may be required for lighting, fans, charging points, kitchen equipment, water pumps, refrigeration, office equipment and other appliances. Electrical load should be calculated before installation and proper electrical protection and safety provisions incorporated.

Ventilation & thermal comfort

Design should consider window placement, cross ventilation, roof design, insulation, ceiling height, fans and air-conditioning where required. For hot regions, insulated panels such as PUF can be considered based on project thermal requirements — see our PUF panel thickness guide.

Drainage & waste management

A large worker camp generates wastewater and solid waste. Planning should include toilet and bathroom drainage, kitchen wastewater, stormwater management, solid waste collection, waste storage and site cleaning. Poor drainage can create serious problems during monsoon conditions.

Fire & safety planning

Worker accommodation should include appropriate safety provisions according to building type, occupancy and applicable requirements. Depending on the project, consider fire extinguishers, emergency exits, escape routes, emergency lighting, fire alarm systems where required, signage, electrical safety and emergency access. Final design should be reviewed against applicable local regulations and project requirements.

How much does a 200-worker labour camp cost?

There is no universal fixed price. Cost depends on structural system, wall panels, roofing, flooring, doors/windows, insulation, electrical, plumbing, sanitary, water, drainage, kitchen, mess, toilets, bathrooms, common areas, site preparation, foundation, transportation, installation, project location, specifications and finishing level.

A project-specific BOQ (Bill of Quantities) is the right way to determine the actual cost. For a planning method, read labour colony cost per bed.

Why saving money on the wrong components can backfire

A labour camp should be evaluated on initial cost, speed, worker comfort, maintenance, operating cost, relocation potential and lifecycle. Choosing inadequate insulation may reduce initial cost but increase thermal discomfort and cooling requirements. Reducing sanitation facilities too aggressively can create operational and maintenance problems. The objective should be value engineering, not simply the lowest quotation.

Prefab labour camp vs traditional construction for a 30-day project

Prefab: generally faster installation, lower wet construction, more controlled site labour, off-site manufacturing, modular design, potential relocation/reuse and strong potential for rapid mobilisation.

Traditional brick: generally slower for tight schedules, more site-based wet work and multiple construction trades, but established for conventional permanent construction.

Actual performance depends on planning, contractor capability, design and site conditions.

The key to a 30-day labour camp: parallel execution

Divide the project into parallel workstreams:

  • Engineering: Design → Drawings → Specifications → Approval
  • Manufacturing: Materials → Fabrication → Panels → Doors/Windows → Roofing
  • Site preparation: Levelling → Foundation → Drainage → Utilities
  • Logistics: Packing → Transportation → Unloading → Storage
  • Installation: Structure → Panels → Roof → Flooring → Services
  • Handover: Testing → Inspection → Cleaning → Defect correction → Occupancy

Common mistakes when setting up a labour camp

  1. Starting construction without a final layout.
  2. Ignoring toilet and drainage planning.
  3. Waiting for materials before preparing the site.
  4. Choosing panels only on price.
  5. Forgetting transportation costs and logistics.
  6. Not planning for future expansion.
  7. Not reserving time for final inspection and handover.

Can a 200-worker labour camp be expanded later?

A modular prefab approach can potentially allow additional accommodation blocks, toilets, utility spaces or other facilities to be added, depending on the original design and available site area. Future expansion should be considered during initial planning.

Can the labour camp be relocated?

A suitably designed prefab system may potentially be dismantled, transported and reassembled at another project location. This can be relevant for road, railway, mining, infrastructure, industrial and remote EPC projects. Feasibility depends on the structural system, connections, component condition, transportation costs and new site requirements.

30-day checklist for project managers

  • Worker capacity confirmed
  • Room occupancy decided
  • Site dimensions verified
  • Layout approved
  • Accommodation area calculated
  • Toilet/bathroom requirements determined
  • Kitchen and mess requirements finalised
  • Electrical load calculated
  • Water requirement assessed
  • Drainage planned
  • Structural system selected
  • Panel specification finalised
  • Foundation/site preparation started
  • Manufacturing schedule confirmed
  • Transportation plan prepared
  • Installation sequence finalised
  • Safety requirements reviewed
  • Quality inspection planned
  • Handover date confirmed

Final takeaway

Setting up accommodation for 200 workers in 30 days requires parallel planning, early design finalisation, off-site preparation, site readiness, organised logistics and a well-managed installation process.

Prefab construction can be particularly useful where mobilisation needs to be fast, accommodation is temporary or semi-permanent, the site is remote, the workforce is large, future expansion may be required, or relocation/reuse is valuable.

The key principle is: Don't wait for one activity to finish before starting the next. Prepare the site while the prefab components are being manufactured.

Need a 200-worker labour camp?

Prefabshala provides prefab construction solutions for businesses, contractors, EPC companies and project sites — 200-worker labour camps, worker accommodation, labour colonies, site offices, staff quarters, kitchen/mess blocks or a complete site township.

Share: number of workers, project location, required beds, available site area, project duration, required facilities and expected installation timeline. Call 8510015200 / 9217212997 or get a labour camp estimate.

Back to Blogs Discuss your project

Labour Colony

Frequently Asked Questions

Can a 200-worker labour camp be built in 30 days?

A 200-worker prefab labour camp may be achievable within a 30-day mobilisation window when design, manufacturing, site preparation, logistics and installation are planned in parallel. Actual timing depends on project size, specifications, site readiness, approvals, material availability and transportation.

What is the best construction method for a fast labour camp?

Prefab can be well suited because components can be prepared off-site while site preparation happens simultaneously.

How many rooms are required for 200 workers?

It depends on occupancy. At eight workers per dormitory, 25 dormitory rooms would accommodate 200 workers, excluding toilets, kitchen, mess, common areas and other facilities.

What facilities are required?

Dormitories, beds, toilets, bathrooms, kitchen, dining/mess, drinking water, electricity, ventilation, drainage, waste management, storage, common areas and safety facilities may be included.

How much does a 200-worker prefab labour camp cost?

There is no fixed price. Cost depends on design, area, panel specifications, structure, toilets, kitchen, electrical/plumbing, foundation, transportation, installation and finishing. A project-specific BOQ is required.

Can prefab labour accommodation be relocated?

Some systems can be designed for dismantling and reassembly. Feasibility depends on the system, component condition, logistics and new site.

Is PUF panel suitable for labour camps in India?

PUF panels can be considered where thermal insulation is required. Thickness should be selected based on climate, building use and project requirements.

Can the camp be expanded from 200 to 300 workers?

A modular design can potentially allow future expansion if sufficient site space and utility capacity are planned.

Is prefab suitable for remote construction sites?

Prefab can be useful because much component preparation can happen away from the project location, reducing prolonged on-site construction work.
